Pylon Sign Installation: Expert Guidance for Safe, Compliant, and Durable Installations

Updated: Oct 5
A good pylon sign does a lot of heavy lifting. It tells drivers where to turn, makes your business easy to spot from the road and keeps working day and night, whatever the weather. But a sign standing several metres tall is also a serious piece of engineering, and getting the installation wrong can mean anything from a sign nobody can read to a structure that simply is not safe.
The good news is that most problems are avoidable with the right planning. In this guide, we walk through what really matters, from surveying the site and getting permission to laying foundations and signing off the finished sign. The same principles apply to smaller totem signs at business park entrances, car parks and retail sites. At The Sign Company UK, we help businesses plan and install pylon and totem signs across the country, and these are the questions we work through on every project.
Key Takeaways
A proper site survey decides where your sign will be most visible and what foundation it needs.
Planning consent, structural design and electrical safety must be sorted before installation day.
Experienced installers save time and money by spotting problems early, not halfway through a dig.

Planning Your Pylon Sign
The most successful projects start with the ground beneath the sign and the rules around it. Whether you are planning one large pylon or a set of totem signs across a site, getting accurate information and approvals in place first will save you from delays and unexpected costs.
Start With a Proper Site Survey
A ground investigation tells us the soil type, how deep firm ground sits and whether groundwater could be an issue. That decides how big the foundation needs to be and whether a standard concrete base will do or piled foundations are needed.
Next, we check what is buried nearby. Gas pipes, water mains, fibre cables and power lines often run exactly where you would like to dig, so utility records and cable scanning are essential before any excavation. Overhead power lines, trees and building overhangs also affect where a tall sign can go and how a crane can lift it safely.
Think About Who Needs to See It
A pylon sign is only useful if people can read it in time to act. On a busy road, drivers may have just a few seconds, so consider which direction traffic approaches from, how fast it is moving and what might block the view, such as trees, parked lorries or other signs. As a rule, faster roads need bigger, simpler signs with less text. Totem signs at a car park entrance can carry more detail because people are moving slowly and already looking for directions. Lighting matters too, as halo-lit, face-lit or internally illuminated panels keep your sign working after dark, when many drivers are looking for somewhere to stop.
It is also worth planning for wind, flood risk and access. Tall signs catch a lot of wind, especially on exposed or coastal sites, and there needs to be room for a crane on installation day and safe access for cleaning and maintenance afterwards.
Planning Permission and Compliance
Most pylon signs need formal approval, and illuminated ones almost always do. In England, signage falls under the Town and Country Planning (Control of Advertisements) Regulations. Some smaller signs benefit from deemed consent, but large freestanding and illuminated signs usually need an application to the local council, which typically aims to decide within eight weeks.
A strong application includes a site plan, elevation drawings, materials, lighting details and confirmation of the structural design. Photomontages showing the sign in its real setting help planning officers see exactly how it will look.
Behind every safe pylon sign is a structural design, usually signed off by an engineer, that accounts for its size, local wind loads and ground conditions.
Illuminated signs must be wired to BS 7671, the UK wiring regulations, with suitable RCD and surge protection, and installed by a qualified electrician.
Consent often comes with conditions too, such as brightness limits or set hours of illumination, so keep a record and make sure your lighting follows them. Ignoring a condition can lead to enforcement action, which is far more costly than getting it right first time.

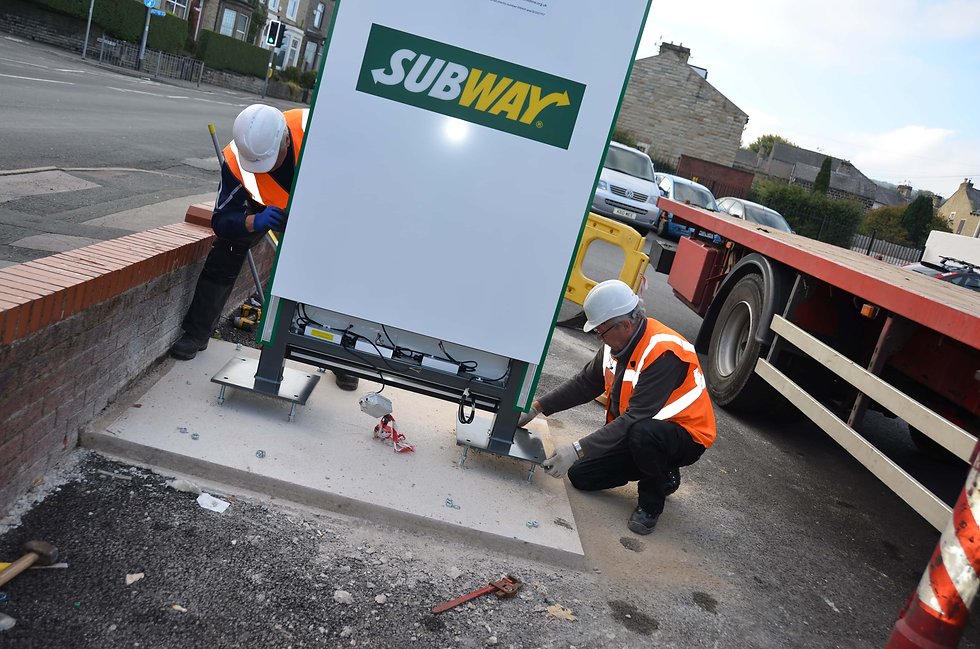

The Professional Fitting Process
This is the part most people never see, but it is where a sign's long-term safety is really decided. At The Sign Company UK, every installation follows the engineer's drawings, building regulations and manufacturer's instructions from the first peg in the ground to the final sign-off.
Getting the Foundation Right
Using the survey findings, the team marks out each column position with pegs and laser levels, matching the structural drawings precisely. Holes are dug to the engineer's specified depth and width, and reinforcement cages go in before the concrete is poured.
Concrete is mixed to the specified strength and left to cure. This is one step you cannot rush, as concrete typically reaches full design strength after around 28 days, and the engineer will advise when the structure can be lifted on. Anchor bolts are set in a template that holds them level and upright while the concrete hardens. Once cured, the baseplate is levelled with packers, bedded on non-shrink grout and the anchor nuts are tightened to the engineer's specified torque.
Safety on Site
Before work starts, you should receive a site-specific risk assessment and method statement, and the team should hold a short toolbox talk each day covering the lifting plan and emergency procedures. Everyone wears the right protective equipment, including fall-arrest harnesses at height, and lifts are coordinated by a trained banksman using certified equipment inspected in line with LOLER regulations.
Electrical supplies are isolated and locked off before illuminated parts are connected, and barriers keep pedestrians and vehicles safely clear of the work area, which matters on busy retail parks and forecourts. Every check is recorded, along with welding, bolting and electrical certificates, giving your sign a clear history for future maintenance.

For more expert insights, explore our blogs on “Illuminated Totem Signs” and “Totem Sign Manufacturer” to enhance your signage design and sourcing decisions.
Final Checks and Handover
Before the team leaves, the sign is checked to confirm it is perfectly upright, matches the drawings and has every bolt tightened correctly. If your pylon or totem signs are illuminated, a qualified electrician tests the installation and issues a certificate only once every result meets BS 7671. Lighting, timers and daylight sensors are checked to make sure they switch on and off as they should.
You then receive a handover pack with marked-up drawings, torque records, concrete test results, electrical certificates and a maintenance plan covering bolt checks, cleaning and LED replacement. Look after it, and a well-installed pylon sign or set of totem signs can keep doing its job reliably for many years.
Frequently Asked Questions
Do I need planning permission for a pylon sign?
In most cases, yes. Large freestanding and illuminated signs usually require advertisement consent from your local council.
What is the difference between pylon signs and totem signs?
Pylon signs are typically taller and designed to be seen from roads at a distance, while totem signs are usually lower, freestanding signs used at entrances, car parks and within sites.
How long does installation take?
The installation itself often takes one or two days, but surveys, design, consent and concrete curing can take several weeks, so it pays to start early.
How long does a pylon sign last?
With a properly engineered foundation, quality materials and regular maintenance, a pylon sign can last well over a decade, although LED modules and finishes may need attention sooner.
